Tlou Energy Provides Second Quarter Operational Update

25/07/2023

Highlights

  • Lesedi 6 production pod drilling completed
  • The 66kV overhead transmission line is approximately 79% complete
  • At the quarter end the Company had ~A$6.85m cash on hand (unaudited)

Activities

Tlou Energy continues to have three key project areas referred to as the:

  • Lesedi Project - focused on gas-to-power development as well as exploration and evaluation.
  • Mamba Project - focused on exploration and evaluation.
  • Boomslang Project - focused on exploration and evaluation.

Lesedi Project

The Lesedi project is Tlou's most advanced. At Lesedi the Company is developing a proposed 10MW gas-to-power project. The Lesedi project area has four Prospecting Licenses (PL) and a Production Licence which is the key focus area for the development of Tlou's independently certified gas reserves and contingent resources. The table below summarises the status of the Lesedi licences:

Licence

Expiry

Status

Production Licence 2017/18L

Aug-42

Current

PL001/2004

Sep-23

Current

PL003/2004

Sep-23

Current

PL035/2000

Mar-25

Current

PL037/2000

Mar-25

Current

PL renewal applications are submitted three months prior to expiration. Renewal applications were submitted for PL001/2004 and PL003/2004 during the quarter.

Gas to Power Project

The first electricity to be generated at Lesedi is planned to go towards satisfying the 10MW Power Purchase Agreement (PPA) with Botswana Power Corporation (BPC) the national power utility. The Lesedi project currently has several components of the development process underway including the construction of transmission lines, substations, a field operations facility and generation site as well as production well drilling.

Transmission Line Construction

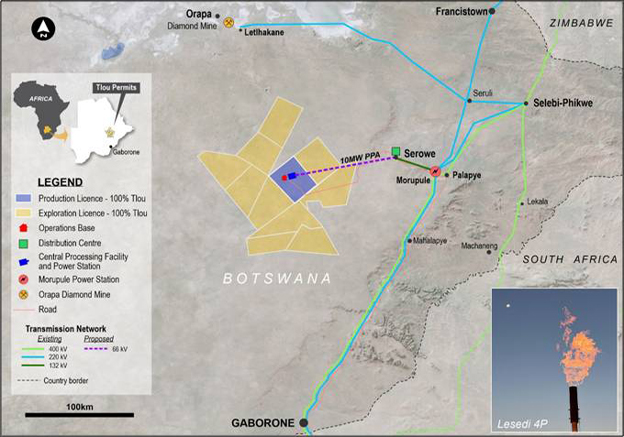

The Lesedi project is approximately 100km from the nearest BPC substation connection in Serowe. To connect to the national grid, the Company is undertaking the construction and installation of a 100km 66kV transmission line. This, together with the ongoing drilling program should enable the Company to connect and provide electricity into Botswana's power network.

The construction of the 66kV transmission line is being carried out by Zismo Engineering Pty Ltd with progress at the end of June 2023 estimated at approximately 79%. The expected July 2023 completion date has been pushed back due to a delay in availability of line conductors as well as hard rock excavation and the discovery of previously unknown sub-surface services with has slowed progress. However, the transmission line construction remains on target to be completed well in advance of proposed first power generation.

Substation Construction

Substations are required at either end of the transmission line, one to tie Tlou's generators to the transmission line at Lesedi and another to integrate the line with the existing BPC substation at Serowe. The planned substation at Lesedi is currently designed for an initial 5MW of power which can be upgraded to 10MW at a later stage with the project anticipated to be completed in early 2024. The Company is now assessing options that may allow the current substation design to be adapted to facilitate expansion beyond 10MW.

Drilling Operations

During the quarter the Company began drilling the latest production pod, Lesedi 6, the first of a series of new pods (funds permitting) that the Company plans to drill as part of the 10MW gas to power project. Lesedi 6 comprises one vertical production well (Lesedi 6P) intersected by two lateral wells (Lesedi 6A and 6B) drilled horizontally through the target reservoir section for several hundred metres.

Lesedi 6P - Vertical Production Well

This well was drilled to a depth of 589m and intersected 6m of the target lower Morupule coal. Well casing was cemented in place, with fiberglass casing over the target coal seam underreamed to expose the coal to the well bore to facilitate dewatering and gas flow.

Lesedi 6A and Lesedi 6B - Lateral Wells

The top hole (or vertical) sections of Lesedi 6A and Lesedi 6B were drilled during the quarter. Both were drilled to a depth of 150m and cased with steel casing and cemented. Following cementing, the wells were deepened in preparation for running the directional tools which are required to complete the lateral section of the well. Drilling of the lateral sections commenced thereafter with both lateral sections successfully intersecting Lesedi 6P post quarter end.

A diagram of a well Description automatically generated with low confidence

Core-hole drilling

In addition to the Lesedi 6 production pod, a core-hole was drilled close to the vertical sections of Lesedi 6A and 6B. The objective of the core-hole was to provide further geological control. In addition to providing coal and gas content data, the core-hole accurately determined the top and bottom of the target coal seam. The core-hole was completed and logged after reaching a total depth of 535m and intersecting 6m of coal. A total of 18 coal samples were taken and placed in desorption canisters for further analysis.

A further core-hole was commenced prior to quarter end which was located close to where another new production pod (Lesedi 7) is proposed to be drilled at a later date.

Mamba Project

The Mamba project is in the exploration and evaluation phase with further operations required on the operating licences. It consists of five Prospecting Licences covering an area of approximately 4,500 Km2. The Mamba area is situated adjacent to Lesedi. In the event of successful drilling results at Mamba, it is envisioned that this area would be developed as a separate project from Lesedi. The Mamba area provides the Company with flexibility and optionality. The status of the Mamba licences is as follows:

Licence

Expiry

Status

PL 237/2014

September 2023

Current

PL 238/2014

September 2023

Current

PL 239/2014

September 2023

Current

PL 240/2014

September 2023

Current

PL 241/2014

September 2023

Current

PL renewal applications are submitted three months prior to expiration. Renewal applications for all Mamba project licences were submitted during the quarter.

Boomslang Project

Prospecting Licence, PL011/2019 designated "Boomslang", is approximately 1,000 Km2 and is situated adjacent to the Company's existing licences. To date, the Company has not carried out ground operations in the Boomslang area. The status of the Boomslang licence is as follows:

Licence

Expiry

Status

PL 011/2019

June 2024

Current

PL renewal applications are submitted three months prior to expiration.
